Resource Capacity Planning: Spot Burnout Early
Capacity planning is just arithmetic that most teams never do: effort scheduled for a person, divided by the hours they actually have. Done weekly and visually, it prevents most overload before it starts.

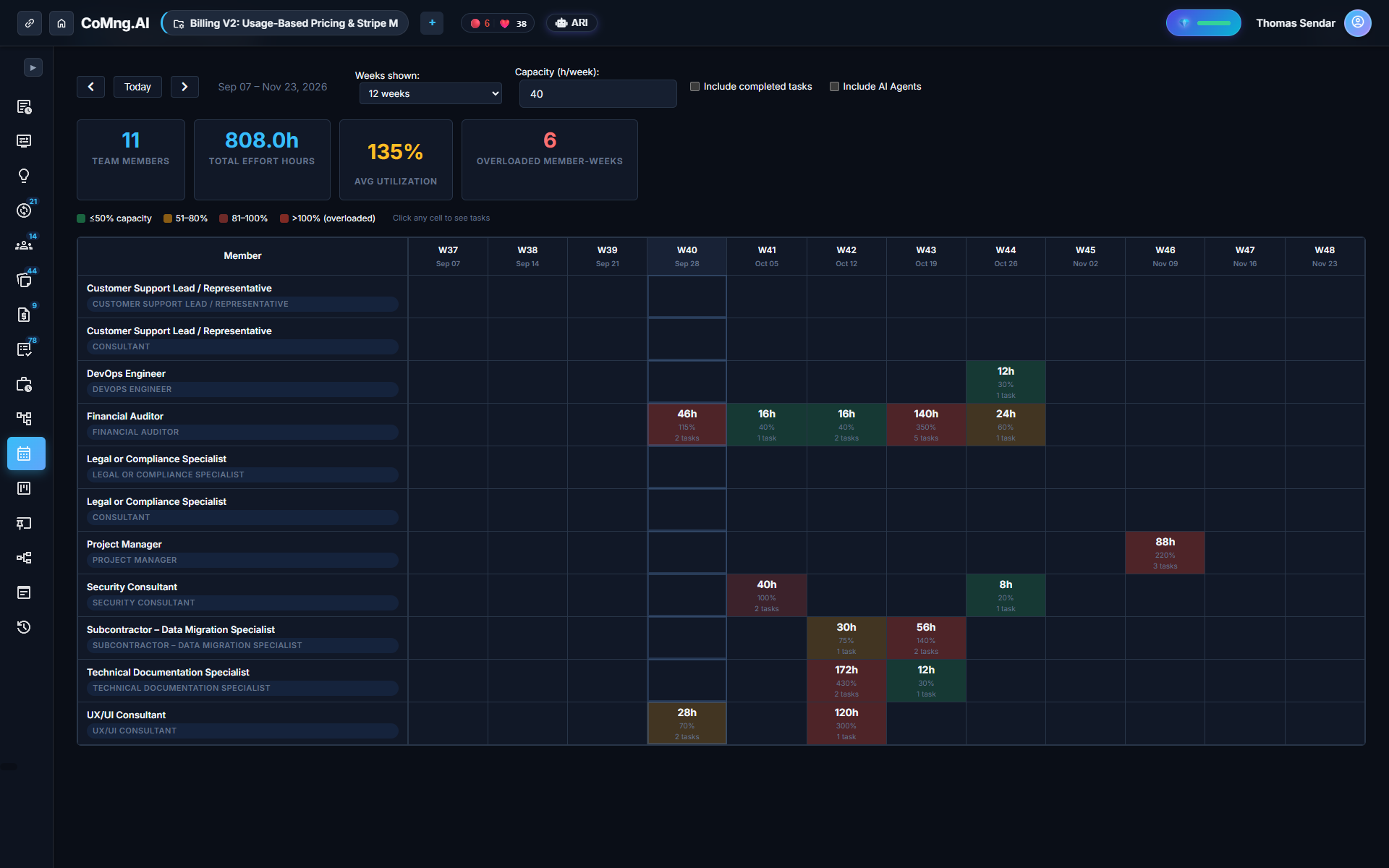

Resource capacity planning compares the effort scheduled for each person with the hours they actually have, per week. In CoMng.AI, give every task effort, an owner and a due date and the Resource Planner builds the heatmap: green up to 50%, amber to 80%, red to 100%, dark red above, with a 40-hour default week.
- The formula: scheduled effort hours in a week divided by that person's weekly capacity, per person, per week.
- Data you need: every task needs an assignee, an effort estimate and a due date.
- Targets: average utilization around 70 to 80% leaves room for unplanned work.
- Fix tools: Smart Assign, date changes on the Tasks page, and Pulse alerts that pair overloaded people with spare capacity.
What Capacity Planning Actually Is
Capacity planning answers one question honestly: can the people we have do the work we scheduled, in the weeks we scheduled it? It needs three inputs: how much work (effort), when it is due, and how many hours each person really has.
The common failure is not the maths. It is that the inputs live in different places: effort in estimates, dates in a plan, availability in someone's head. A capacity heat map joins them.
Setting It Up in CoMng.AI
Give every task an effort value
The Resource Planner only counts tasks that have an effort figure. Tasks without effort are invisible, so this single habit makes or breaks the picture.
Assign and date the work
Tasks need an assignee and a due date; the planner distributes each task's hours across the weeks it falls in.
Set realistic capacity
Capacity defaults to 40 hours a week. Reduce it for part-time people or people shared across projects, otherwise the grid overstates availability.
Choose the horizon
View 8, 12, 16 or 24 weeks. Twelve is a comfortable planning horizon for most projects.
Across Projects, Not Just One
People are rarely on one project. CoMng.AI also provides an organization-wide Resource Planner showing each person across every project at once, plus an org-wide Gantt, so a specialist who looks fine on Project A and impossible on Project B shows up honestly. Cross-project team reuse lets AI staffing suggestions draw on the whole organization's talent pool, not just the project's roster.
From a Red Cell to a Decision
Click any coloured cell for a slide-in panel of the tasks that drive it, with status and hours. Then decide between four moves: shift a date, reduce or split the task (the Break Down Task action turns one task into subtasks in a click), reassign it, or accept and escalate by raising a change request with the schedule impact.
Let Pulse Watch It for You
Project Pulse includes each member's workload for the next seven days among its signals, and flags overloaded members alongside people with spare capacity. It can prepare a rebalancing change request, or run Auto-Assign Tasks straight from the alert. Auto-assign makes real changes immediately, so check the assignment summary it shows.
Healthy Targets
| Metric | Healthy range | Why |
|---|---|---|
| Average utilization | 70 to 80% | Leaves buffer for unplanned work and review |
| Overloaded member-weeks | As close to 0 as possible | Each is a direct measure of scheduling risk |
| Peak-week utilization per person | Under 100% | Over 100% means a slip or overtime is already built in |
| Tasks without effort | 0 | They are invisible to capacity planning |
- Availability tracked in a spreadsheet
- Overload found when quality drops
- Planning debates based on opinion
- Workload computed from task effort and dates
- Overload found weeks ahead
- Planning debates based on the same grid
About CoMng.AI
CoMng.AI is an AI-native project management platform that generates a project's plan, tasks, risks and budget from a description or document, monitors project health in real time, and gives both human teams and AI coding agents live access to the same project data, with a person approving every AI-generated change.
Find the slip while it is still a calendar edit
Import or generate a plan and let CoMng.AI show you which milestones are at risk before your stakeholders do.
Frequently Asked Questions
How do you calculate resource capacity?
For each person and week: sum the effort hours of their tasks that fall in that week and divide by their weekly capacity (40 hours by default in CoMng.AI). Over 100% means the schedule asks for more than the person has.
What utilization should I aim for?
Around 70 to 80% on average. It balances using the team well against leaving buffer for unplanned work.
Why is a team member missing from the CoMng.AI Resource Planner?
Members appear only when assigned to tasks that have both an effort value and a due date in the visible window, and when they are active on the team.
Does the planner cover multiple projects?
The project planner covers one project; an organization-wide Resource Planner shows each person across every project at once.
How do I fix an overloaded week?
Click the cell to see the tasks, then change a date, split or shrink the task, reassign it, or run Smart Assign on unassigned work. Re-check the heatmap afterward.
